Craning the World’s Fastest Installing Elevator Into Place

When craning the world’s fastest installing elevator in place, there are three different configurations to choose from:
  • Two cranes: A larger one lifts the top end and uprights it, while a smaller one lifts the bottom end, then gently lowers it to the ground.
  • One crane with 2 independently operating hooks that do what 2 cranes would do. (see video above)
  • One crane that lifts the tower off the truck, then sets it on the ground re-rigs to the top only, and tilts it upright.

All of these options are acceptable. The first two save a small amount of time, but may cost a bit more.

Determine Crane Size

The crane company needs to determine the crane size. To do this, they need:

Tower dimensions: Look up on your approval drawings.

Tower weight: Below you will see a chart that indicates the estimated weight of a standard tower. For specific weight estimates regarding Machine Roomless or traction elevators, contact PME for a more concise weight estimate. Keep in mind that for traction elevators, the total weight of the elevator can increase due to counterweights within the unit. A modular machine room weighs 5-6,000 lbs.

Standard Tower Weights
Hoistway
Length
Weight WF/WFR Weight SF/SFR Weight SLF/SLFR
25' 19000lb 20000lb 21000lb
30' 20000lb 21000lb 22000lb
35' 23000lb 24000lb 25000lb
40' 26000lb 27000lb 28000lb
45' 27500lb 29000lb 30000lb
50' 29000lb 30000lb 31000lb
Site Access

The crane company needs to visit the site with the general contractor. The GC will show them specifically where they can set up the crane for elevator installation and where the elevator will be going.

How long is the crane needed?

Four hours is all you need when craning in the world’s fastest installing elevator. This will cover the time for crane setup, rigging, tower set and plumbing, unrigging and crane pack up.

Add one hour for each additional tower.

 Crane Setting Process

The day of the installation arrives! Here are the steps to the complete placement:

  1. Truck arrives, untarps load
  2. Crane removes modular machine room or pallet with power unit & controller
  3. Rig head and tail of hoistway
  4. Crane lifts hoistway off truck bed
  5. Truck drives away or crane swings hoistway off truck bed (depends on job site layout)
  6. Crew removes shipping brackets
  7. Crane upends hoistway
  8. Rigger removes lower end rigging
  9. Crane swings hoistway into pit
  10. Crew and crane communicate to level and plumb hoistway, bolt down
  11. Crew removes upper rigging
  12. Crane sets modular machine room (if ordered)

Below you will find rigging instructions for elevator installation and other information that will make the process go smoothly.

The set consists of three steps: lifting the tower off the truck, uprighting the tower, and setting the tower in the pit. Also, make sure proper rigging is provided.



How is the elevator rigged?

Diagram for craning the world's fastest installing elevator into place

This diagram shows the recommended rigging for elevator installation.

Lifting the Tower

Craning the modular elevator into place is an easy process, but should be completed in a systematic way to ensure safety and to retain the structural integrity of the modular elevator. While it may sound difficult, this process has been completed hundreds of times. The total weight of the modular elevator can range between 19,000 and 40,000 lbs. depending on the total size and means of conveyance. Please use appropriate sized straps, cables and clevises and ensure all safety precautions are observed.



Top of tower rigging: There are two large lifting lugs at the top of the modular elevator tower designed to handle the weight of the entire hoistway. Place a clevis through the 2″ holes on each lifting lug.

Bottom of tower: Next comes attaching the crane to the bottom of the hoistway. Place Straps around columns just above base plates. With the straps in place you are ready to lift the elevator off the back of the truck.

Lifting the tower: After securely rigging the top and bottom of the tower, the crane lifts up the tower and the truck drives away. Multi-piece towers have connection plates at the joints and should be rigged with clevises through the 1 3/8” holes.

Elevator installation requires rigging the crane to the modular elevator.

Rigging the top

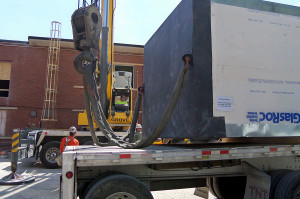

To install a modular elevator, the lifting lug on the top of the hoistway needs to be used when craning it into place.

Lifting lug up close



Elevator installation requires rigging the crane to the modular elevator.

Rigging the bottom

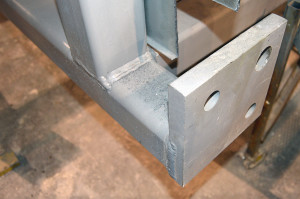

Base plate for a modular elevator being installed.

Base Plate

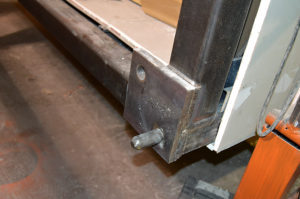

Connecting plate for a modular elevator.

Connection Plate


Uprighting the Tower

Option 1: If the crane has 2 independently operating hooks, raise up the top of the tower while simultaneously lowering the bottom of the tower for elevator installation: a midair tilt-up. Using two cranes can be more efficient; however, the extra cost is not necessary.

Option 2: If the crane has only one hook, then set the tower on the ground, remove the rigging on the bottom, and then tilt the tower up, pivoting on the base plates.

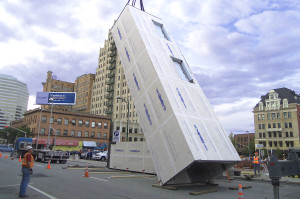

Uprighting the hoistway in an elevator installation.

Uprighting the hoistway for installation

Setting the Tower in the Pit

If still attached, remove the rigging at the bottom. Lift the tower up by the lifting lugs and set it into the pit. As you plumb and level it, there will be some communication between the install crew and the crane to lift up, adjust the leveling nuts, and set back down.

Once the tower is level and plumb, remove the top rigging (make sure to have a lift on hand if there is no roof access) and the crane is done.

If the elevator has more than one piece, rig them as indicated, and lower them onto the lower tower. The installation crew will bolt them together. There is no need for additional plumbing/leveling.
